BairesDev

Product Manager vs. Project Manager: Decision Rights, Not Job Descriptions

How Engineering Leaders Can Structure the PdM-PjM Partnership to reduce thrash and improve delivery predictability

Last Updated: April 1st 2026
Technology
11 min read
Verified Top Talent Badge
Verified Top Talent
Renata Matos
By Renata Matos
Product Manager18 years of experience

Renata is a product manager with 18+ years of experience combining technical expertise with strategic product vision. She has worked at Accenture and advanced from quality assurance to product ownership at CESAR.

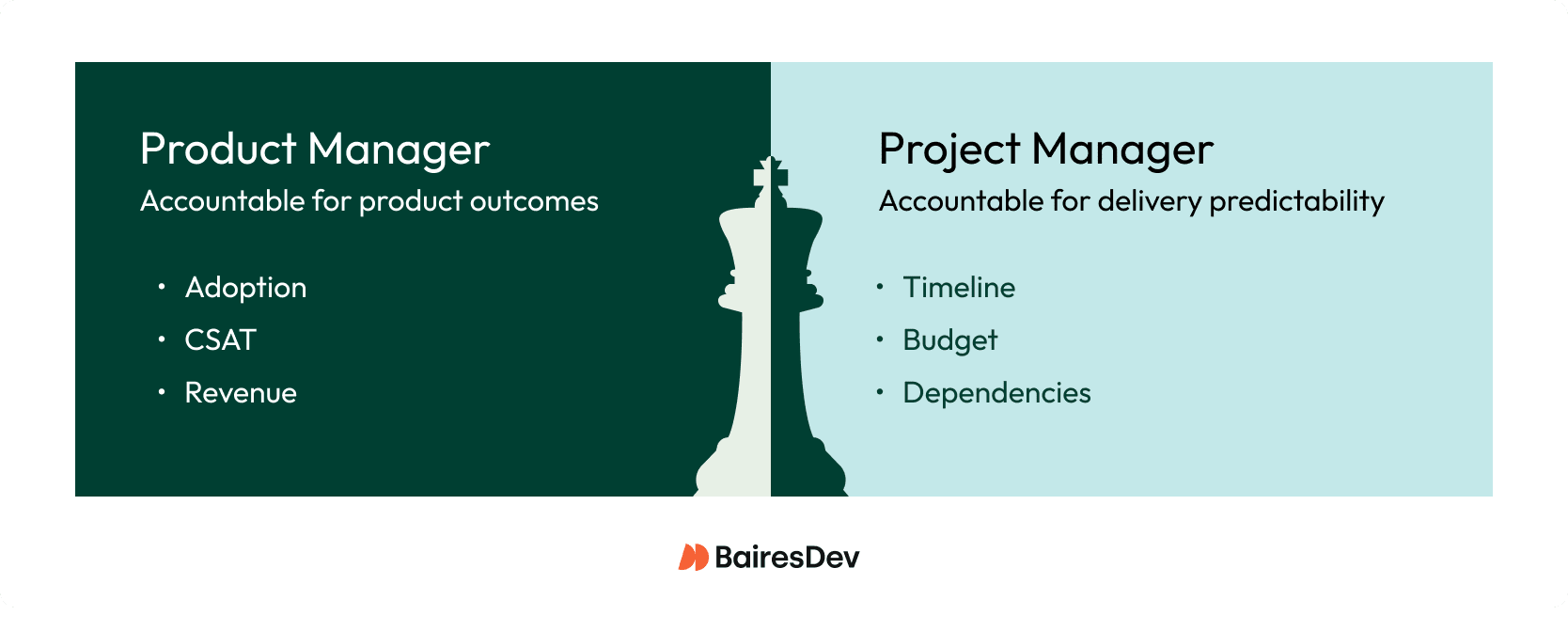

Product manager vs project manager comparison illustration using chess strategy and planning visuals to represent differences in roles, responsibilities, and decision-making focus.

TL;DR

  • Product managers own what gets built and why — measured by adoption, revenue, and customer satisfaction.
  • Project managers own how and when it gets delivered — measured by timeline, budget, and dependency management.
  • Role confusion causes priority wars, mid-sprint scope changes, and stakeholder requests routed directly to engineers.
  • The fix is a decision-rights map, not better job descriptions.
  • Distributed teams need a Definition of Ready to avoid timezone clarification loops.

A product manager decides which problems are worth solving and defines what success looks like. A project manager decides how work gets executed and ensures delivery is predictable. Both roles are necessary, but they hold authority over different domains. When these boundaries are clear, engineering teams move faster. When they blur, no one is accountable for outcomes, and delivery suffers regardless of individual performance

The distinction between a product manager and project manager matters less as a vocabulary exercise and more as an operational necessity.

When these roles blur, engineering teams experience the fallout: shifting priorities mid-sprint, hidden dependencies surfacing at the worst moment, and stakeholders routing requests directly to developers. Even with well-defined boundaries, an underperforming product manager or project manager can produce the same dysfunction. Understanding the key differences between a product manager and project manager is essential for any engineering leader managing cross-functional teams.

Here’s the thing. Most product manager vs. project manager explainers stop at responsibilities. Product managers handle product strategy, while project managers handle execution. That’s accurate but insufficient.

What engineering leaders actually need is a decision-rights framework that clarifies who decides what, which artifacts each product manager and project manager must provide, and how to structure collaboration across time zones. I’ve watched large engineering organizations burn weeks on priority debates that a clear decision-rights map would have resolved in an afternoon.

Decision Rights Matter

  • Role confusion creates “priority wars” and stakeholder chaos
  • Clear accountability boundaries reduce requirement-related rework
  • The real question isn’t “what do they do” but “who decides what”

What Each Role Is Accountable For

Product Manager (PdM): Owns the product outcome. Defines the problem, sets priorities, and decides which customer needs the product should solve. Accountable for adoption, revenue impact, and customer satisfaction. Works under uncertainty — the core question is always which problem is worth solving next.
Project Manager (PM): Owns delivery predictability. Defines the execution plan, manages timelines and dependencies, and keeps stakeholders informed. Accountable for on-time delivery, budget adherence, and risk visibility. Works against defined scope — the core question is always how to ship this reliably.

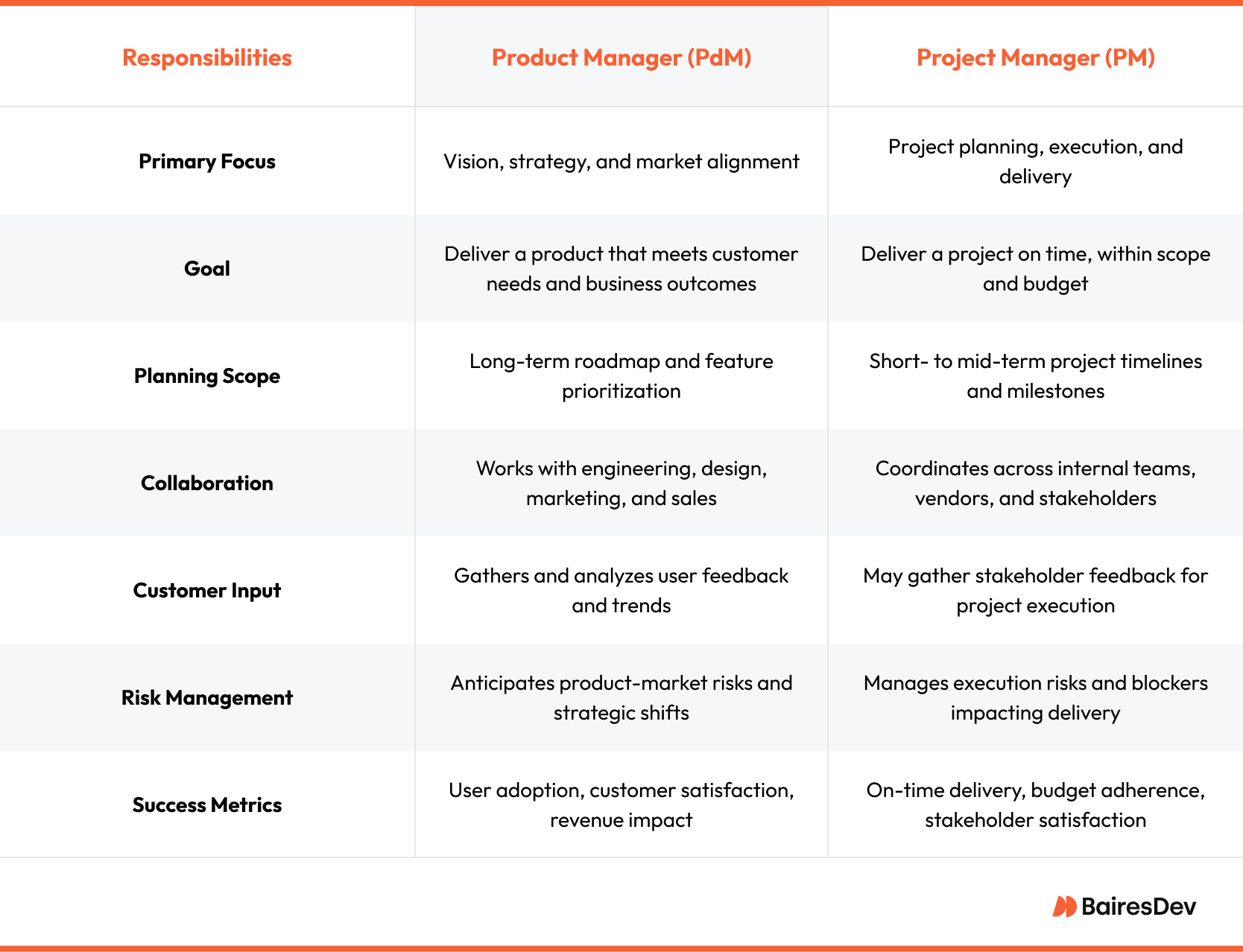

  Product Manager (PdM)  Project Manager (PM)
Primary question  Which problem is worth solving?  How do we deliver it reliably?
Owns  Product strategy, roadmap, priorities  Timeline, budget, dependencies
Success measured by  Adoption, revenue, customer satisfaction  On-time delivery, budget adherence
Works under  Uncertainty — hypothesis-driven  Defined scope — execution-driven
Key inputs  User research, market data, business goals  Capacity, risk register, stakeholder needs
Key outputs  Problem statements, acceptance criteria, roadmap  Milestone plan, RAID log, scope-change log
Escalates to  Product executive  Engineering executive
Typical tools  Productboard, Jira (strategy view), Figma  Jira, Asana, MS Project, Confluence
Can one person cover both?  Yes, up to ~8 engineers. Split roles beyond that.

The product manager’s role centers on product outcomes. Product managers answer why this product exists and what it should become.Comparison of accountabilities: Product Managers own product outcomes (Adoption, CSAT, Revenue) while Project Managers own delivery predictability (Timeline, Budget, Dependencies).

When a product fails to gain traction or misses customer needs, the product manager bears responsibility. Success metrics include adoption rates, customer satisfaction, and revenue impact. The product manager leads product strategy through user research and market research, staying close to market trends rather than buried in execution.

A product manager’s job requires data-driven decision-making and synthesizing customer data into a coherent product vision that guides the product team. Unlike project managers, who operate against a defined scope, product managers work under genuine uncertainty. The core question isn’t how to execute, it’s which problem is worth solving next and whether the hypothesis behind that choice will prove out.

The project manager’s role centers on delivery predictability. PMs answer how work gets done and when it will be complete. That said, “when it will be complete” looks different depending on the nature of the work. For hypothesis-driven initiatives, the project manager structures delivery around test cycles and iteration windows, not a single endpoint. Predictability means each cycle produces a decision.

When releases slip or costs exceed estimates, the project manager bears responsibility. A project management expert brings organization skills and strong communication skills that keep stakeholders informed. They oversee project timelines, manage project resources, and ensure the project team has the necessary resources. PMs also ensure that project planning accounts for dependencies and maintains visibility into performance across the project lifecycle.

Engineering owns technical integrity. The engineering team provides product-oriented feasibility assessments because experiments reduce uncertainty beyond the PoC work.

These boundaries create productive tension. Product managers and project managers work together, but their distinct accountabilities should remain clear. When boundaries between PdM and PM blur, decisions get made by whoever happens to be in the room, causing misunderstandings.

The Decision-Rights Map

Role descriptions tell you what people do. Decision rights tell you who has authority when opinions conflict. When comparing authority, this framework provides clarity that job descriptions lack.

The framework below uses RACI-aligned language: the party that decides holds accountability. Those who advise are consulted before the decision, and those who execute implement what’s been decided.

The same principles apply to multiple roles, ranging from PMs and PdMs, to program managers or project coordinators.

Decision Type Product Manager Project Manager Engineering What Good Looks Like
Priority and sequencing Decides priority based on vision and value Advises on capacity Advises on dependencies Priorities documented with rationale; no mid-sprint changes without approval
Scope changes mid-cycle Decides scope based on priority Decides based on priority Advises on technical impact Change log maintained; impact assessed before approval
Release readiness Decides time-to-market based on milestones and market factors Tracks delivery against target and escalates early Decides technical readiness Checklist completed; all three parties sign off
Quality vs. speed trade-offs Decides acceptable risk Documents impact Advises on technical debt Trade-off explicit and logged; debt tracked
Cost and resource allocation Advises on value priorities Decides within budget Advises on effort Budget current; overruns flagged early
Risk acceptance Decides business-risk tolerance Tracks and escalates Decides technical risk tolerance Risk register maintained; decisions documented

Three principles govern this framework. First, only one product manager or project manager can be accountable for any given decision. Single-point accountability prevents diffusion of responsibility. Second, the person accountable for outcomes holds decision authority. Third, advisory roles must be genuinely consulted, not merely informed.

Escalation Path

Friction between product managers and project managers is inevitable. If your product manager and project manager never disagree, one of them probably isn’t doing their job. Strong problem-solving abilities help, but a clear process matters more.

Step Action Timeframe
1 Direct conversation to clarify positions Same day
2 Classify as value, delivery, or mixed with input from Product and Engineering Within 4 hours
3 Value disputes escalate to product executive Within 24 hours
4 Delivery disputes escalate to engineering executive Within 24 hours
5 Document resolution and communicate Immediately

Minimum Viable Artifacts

Artifacts exist to reduce synchronous clarification. Too few, and product teams waste cycles on questions. Too many, and project documentation becomes a burden. Project management tools can help, but discipline matters more.

Product managers provide:

  • Problem statement describing customer needs and why it matters now.
  • Target user.
  • Success metrics defining what outcomes matter, informed by user feedback.
  • Testable acceptance criteria derived from Product’s success metrics.
  • Priority rationale explaining ranking on the product roadmap.

Project managers provide:

  • Milestone plan with deliverables and dates.
  • RAID log with owners for tracking progress.
  • Communication rhythm for key stakeholders.
  • Scope-change log documenting modifications to project scope and timelines.

Shared artifacts:

  • Definition of Done (completion standards for delivered work) and Definition of Ready (Product confirms the item has sufficient clarity for the team to commit).
  • Release checklist (ownership can be shared, but Project owns releases).
  • Post-launch review questions supporting continuous improvement across the product lifecycle (can be shared, Product usually owns metrics).

These artifacts should fit on single-page documents. If the product manager cannot describe the problem in a paragraph, that suggests they don’t understand it yet.

Operating Cadence and Meetings

Two meetings suffice for most cross-functional teams. The Product Decision Review (weekly, PdM-led) addresses priority shifts, product-roadmap changes, and business goals. The Delivery Risk Review (weekly, PM-led) addresses blockers and timeline risks.

Beyond these, default to async: one update channel plus one canonical document. Cross-functional collaboration depends on eliminating parallel sources of truth. When someone asks a question, the answer should be discoverable without a real-time response.

For distributed teams, define a four-to-six-hour decision window when parties overlap. Set response expectations: 24-hour maximum for non-urgent items, same-day for blockers. When blockers arise outside the overlap window, document them with full context and a specific response deadline rather than scheduling another meeting.

The cadence only holds if engineers and key stakeholders understand the decision-rights map behind it. Who owns priority questions? Who owns timeline questions? Without that clarity communicated, requests may get routed by proximity rather than accountability. A brief onboarding to the RACI at project kickoff removes most of the misdirection.

What Changes for Distributed Teams

When execution spans locations, ambiguity compounds. Stakeholder management becomes complex when product managers and project managers operate across time zones. Distributed teams without intake standards routinely lose days to timezone ping-pong: a requirement arrives, an engineer has a question, the PdM is offline, and the cycle repeats. Stricter intake standards compress that gap significantly.

The handoff between roles must be explicit. The product manager hands off the problem definition, success criteria, and constraints. The project manager hands off the execution plan, identified risks, and dependency requests. Neither party should assume the other has context that wasn’t explicitly transferred.

Distributed teams also need a collaboration contract specifying three things. First, the intake-quality bar defines completeness before the product team commits. Second, the acceptance-criteria format standardizes how the engineering team documents requirements, with Product signing off. Third, the interruption policy specifies who can change commitments.

Teams using the Given-When-Then structure report fewer misunderstandings than those using informal descriptions. The difference between “the system should be fast” and “API responds under 200ms at 95th percentile” determines success.

Distributed Team Checklist

  • One async channel and one canonical document (no parallel sources)
  • Decision windows defined (4-6 hour overlap)
  • Response expectations set (24-hour max; same-day for blockers)
  • Intake-quality bar documented
  • Stakeholder routing enforced (single path for requests)
  • Blocker protocol established (document context, deadline, decision needed)

Common Failure Modes

Three patterns account for most dysfunction between PMs and PdMs.

Product manager becomes project tracker: The product manager gets consumed by status meetings, losing sight of market trends, product strategy, and product vision. The product team drifts while the product manager debugs resource conflicts instead of business objectives.

Fix: Re-establish outcome ownership and product-roadmap discipline. Add project management capacity rather than blurring roles.

Project manager makes priority calls: Under deadline pressure, the project manager cuts project scope without the product manager’s approval. Ships on time but misses value. This undermines product success even when it protects project performance.

Fix: Formal change control. The project manager surfaces trade-offs; the product manager decides.

Distributed clarification loops: Engineers wait because requirements are ambiguous. Days pass while work reports “in progress” but hasn’t progressed. The underlying problem is that “ready to build” is never defined.

A Definition of Ready solves this: a shared checklist that a requirement must pass before the development team commits to it. Typical criteria include a clear problem statement, testable acceptance criteria, and dependency identification. Without it, intake standards are informal and inconsistently applied.

Fix: Establish a Definition of Ready and enforce it at intake. Requirements that don’t pass go back to the product manager, not into the sprint.

Strategic Takeaways

  • Decision rights — not job descriptions — determine whether product and project management work. One owner per decision, no exceptions.
  • The product manager decides what and why. The project manager decides how and when. Engineering decides technical feasibility and readiness.
  • Minimum viable artifacts (problem statement, RAID log, Definition of Ready) eliminate most synchronous clarification requests.
  • Two weekly meetings suffice: Product Decision Review and Delivery Risk Review. Everything else should be async.
  • For distributed teams, stricter intake standards compress timezone clarification loops. A Definition of Ready is not optional.
  • When roles blur, decisions get made by whoever is in the room — not by whoever is accountable.
  • Splitting roles becomes worthwhile once the engineering team exceeds eight to ten engineers.

Frequently Asked Questions

  • In smaller organizations, one person handles both product management and project management. This works if the person separates modes and maintains artifacts for both. The risk: urgent delivery crowds out product strategy and customer needs. As the product team grows beyond eight to ten engineers, splitting roles becomes valuable.

  • The product manager owns acceptable value; the project manager owns deliverable timeframes. When these conflict, the product manager chooses: reduced project scope, extended timeline, or escalate. The project manager surfaces options; the product manager decides. This reflects the core product manager vs project manager distinction.

  • Depends on artifact quality. If the product manager is the primary clarification source, presence helps. If artifacts are complete and a project manager routes questions, attendance may not be necessary. The test: Does the product manager’s absence delay the development team?

  • The Definition of Ready should answer this. Each criterion needs a clear pass/fail condition, detailed enough to test without clarification. The engineering team documents acceptance criteria based on Product’s success metrics; if requirements use subjective language, they go back to the product manager for clarification before entering the queue. Assume every ambiguous phrase costs a day.

  • Route all stakeholder requests through the product manager. Stakeholder management is product domain. If key stakeholders are going directly to engineers or the project manager, the product manager isn’t doing their job. There’s nothing a stakeholder needs where the PdM shouldn’t be involved. The project manager can support intake logistics, but the PdM remains accountable for every stakeholder interaction. That boundary requires executive support to hold, and it needs to be established at kickoff.

  • Weekly minimum, before stakeholder communication. For complex projects or when overseeing projects with many dependencies, the project manager updates after each milestone.
