The best cloud migration tools aren’t hard to find. Building a toolchain that holds up during large-scale cloud migration projects—when you’re moving dozens or hundreds of workloads across multiple teams—is much harder.
It gets harder when real constraints show up: Recovery Time Objective (RTO) and Recovery Point Objective (RPO) targets, regulatory compliance, and on-call teams that inherit whatever you ship. For large enterprises, an hour of downtime can exceed $300K, according to ITIC’s Global Server Reliability Report.
If you treat migration like a shopping exercise, you’ll likely end up with fragmented tooling, dashboards for discovery, and spreadsheets for tracking progress. Then cutover arrives, and you can’t prove your data is complete and correct, can’t roll back cleanly, and can’t define the real failure radius.
The specifics vary by platform, but the pattern doesn’t: every migration tool caps parallelism. If you don’t model those limits early, your plan might look feasible on paper, but fail in execution.
This guide is for teams running multi-workload migrations where downtime, data correctness, and compliance are non-negotiable.
You’ll:
- Lock the migration shape (rehost, replatform, refactor) and wave design
- Define RTO/RPO and identify whether the constraint is application or data movement
- Use a risk-first matrix to evaluate cloud migration tools based on failure modes
- Ensure security, compliance, and day-2 operability are built in
- Keep cloud costs and migration throughput under control

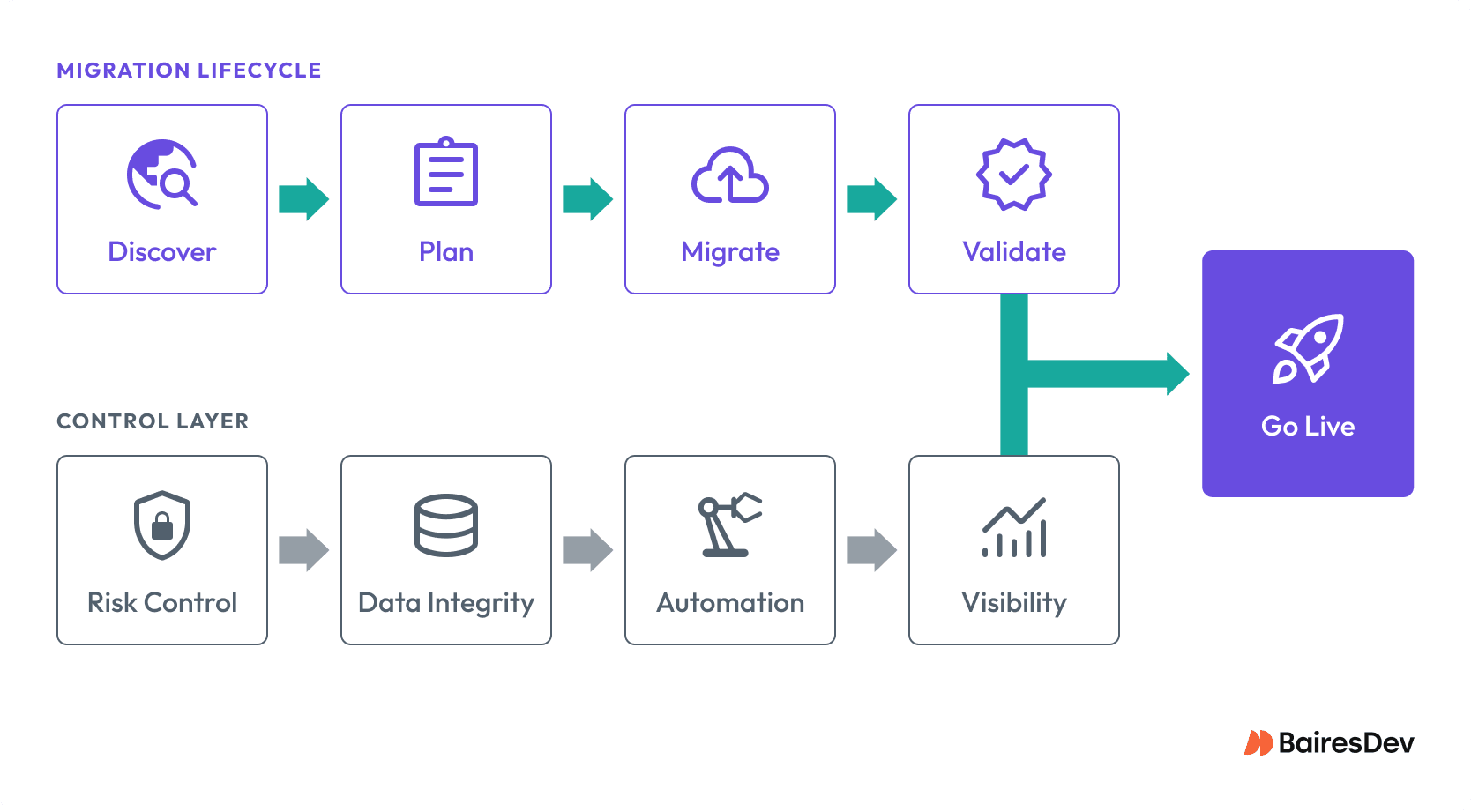

These decisions map directly to how migration actually runs: a sequence of phases, governed by a control layer that ensures risk control, data integrity, automation, and visibility at each step.

A successful migration doesn’t come from adding more engineers or parallelizing blindly. It comes from designing around constraints—quotas, validation, and resource allocation. Tool choice either enables that system or limits it.

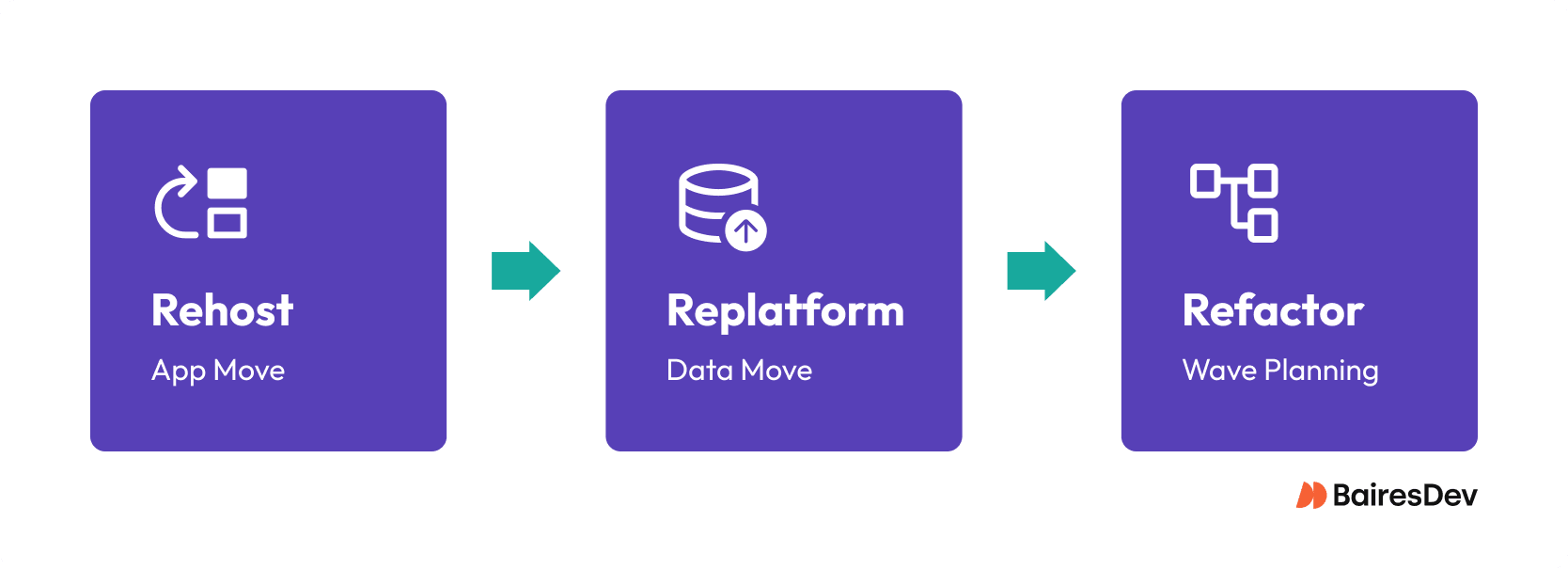

Start With the Migration Shape
If you choose migration tools before locking your migration strategy, you optimize for upfront convenience at the expense of execution risk. You need to decide whether each workload migration is a rehost, replatform, or refactor, and define RTO/RPO targets in the destination cloud environment.

Those decisions determine whether you need replication tooling, data migration pipelines with validation, or deeper modernization support.
For example, a rehost wave with tight RTO and modest RPO pushes you toward continuous replication and a fast rollback when the blast radius grows. But if your RPO is effectively zero—because business operations can’t replay transactions—the constraint shifts. Data validation and correctness become the primary concern, not workload movement.
Write down per-service RTO/RPO targets and wave boundaries (including shared services) in Jira. That becomes the filter for every cloud migration tool you evaluate.
A Risk-First Selection Matrix
You’re not selecting “the right cloud migration tool.” You’re reducing risks like unplanned downtime, data corruption, compliance gaps, and post-cutover instability.
A risk-first matrix forces vendors to answer:
- What risk do you reduce?
- By how much?
- What trade-offs does it introduce?
| Risk category | What to verify | Required evidence (example) |
| Downtime & cutover control | Continuous replication, rehearsable cutover runbooks, rollback speed | Timed cutover rehearsal including DNS, secrets, and dependencies |
| Data integrity & validation | Checksums, row counts, CDC gap detection, reconciliation queries | Automated correctness gate—not only a human spot-check |
| Security & compliance | Encryption paths, IAM model fit, audit logs, separation of duties | Data security team can map tool actions to regulatory controls |
| Operability after cutover | Logs, performance metrics, traces, and incident hooks work day one | Alerts route into on-call and ticketing flow with clear ownership |
| Cost control | Spend guardrails, storage growth, post-move drift detection | Budgets set; surprise spending detected within a day |
| Integration fit | Works with IaC, CI/CD, Jira change tracking, approvals | No parallel tracking systems |
Case in point: Say your wave plan assumes you’ll run 500 servers in parallel: quotas can torpedo your throughput. AWS Application Migration Service (MGN) defaults to 150 actively replicating source servers per Region and 20 concurrent jobs in progress per Region. Your matrix would have to score “factory throughput constraints” and the lead time to raise limits.
Operationally, run the matrix where you already govern risk. Use a weekly migration and modernization review with platform, security, and service owners. Require each score to link to a ticket, runbook, or test artifact. Then you can defend your decision when a cutover goes sideways in the small hours.
Sample Risk-Weighted Decision Matrix
| Criteria | Weight (1–5) | Tool A Score (1–5) | Tool B Score (1–5) | Tool C Score (1–5) |
| Downtime & cutover control (continuous replication, rehearsable cutover, rollback speed) | 5 | |||
| Data integrity & validation (checksums, CDC gap detection, automated correctness gates) | 5 | |||
| Security & compliance alignment (IAM fit, audit logs, encryption paths, separation of duties) | 4 | |||
| Operability after cutover (monitoring integration, alert routing, ownership clarity) | 4 | |||
| Factory throughput & quota constraints (parallel replication limits, appliance/project ceilings) | 4 | |||
| Cost control & spend visibility (replication spend guardrails, drift detection, budgeting hooks) | 4 | |||
| Integration fit (IaC, CI/CD, Jira/ITSM integration, reporting hooks) | 3 | |||
| Migration strategy fit (rehost vs replatform vs modernization support) | 3 |

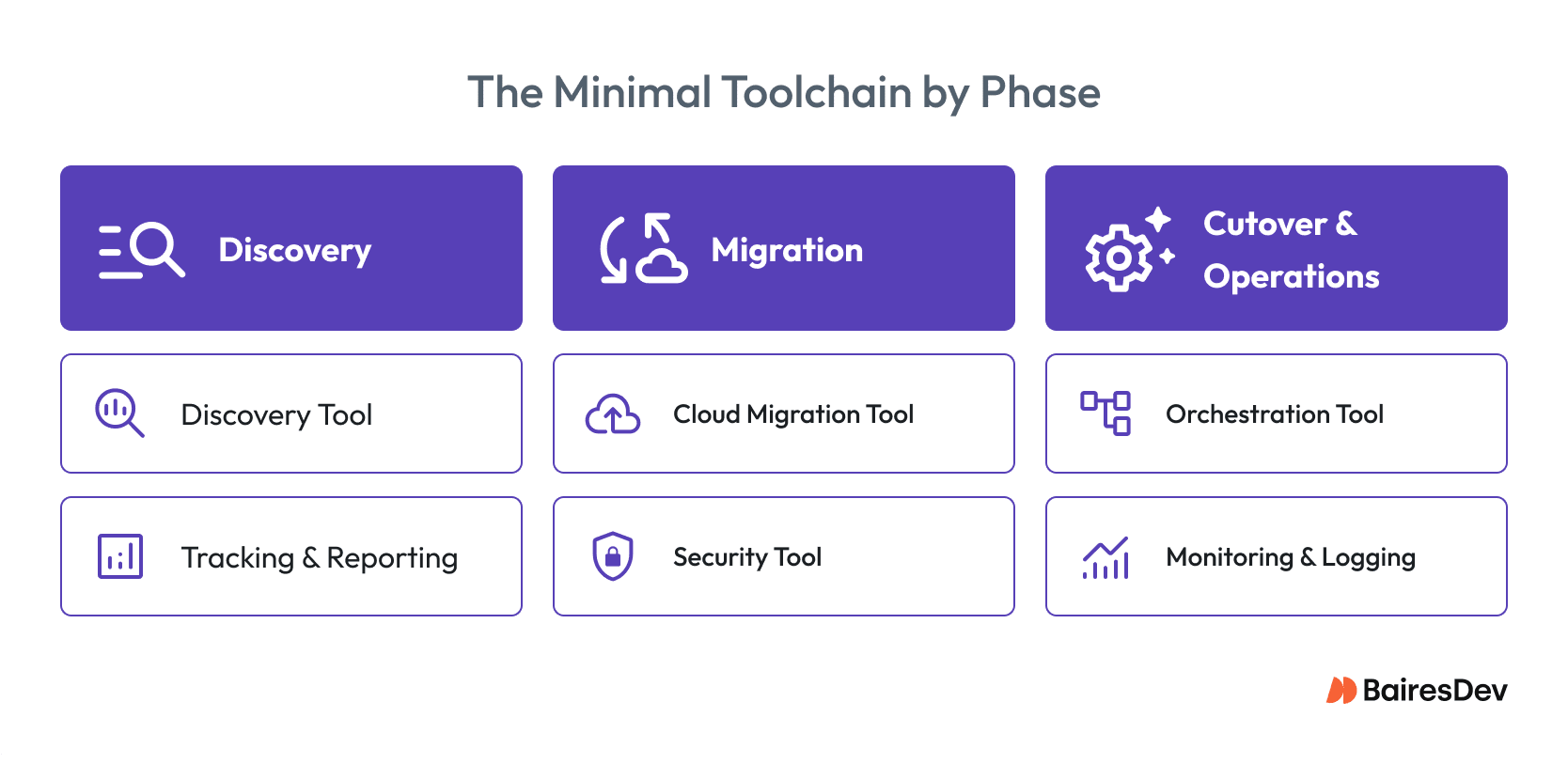

The Minimal Toolchain by Phase
To avoid fragmented tooling, think in terms of a thin control plane that spans the migration process.
In practice, this usually means:
- Jira as the system of record
- GitHub + IaC for execution
- A single observability and performance monitoring stack
Migration tools plug into that system—they don’t replace it.
Every phase needs:
- A single system of record
- Verifiable outputs (not dashboards)
- A way to fail safely

If you can’t point to which tool produces which outputs, you’re not running a migration process—you’re relying on heroics.
Phases 1-3: Discovery, Move Workloads, Move Data
In discovery, focus on inventory and dependency mapping. Native tools like Azure Migrate can work, but scale limits shape your wave design. A single Azure Migrate appliance can discover up to 10K servers and register to only one project. If you want parallel discovery streams, you’ll need multiple appliances and a governance model that keeps projects from fragmenting.
Treat outputs as backlog inputs. Import workloads into Jira with owners, wave assignments, and RTO/RPO targets. Attach assessment and risk data directly to tickets.
For workload migration (e.g., virtual machines and servers), you need repeatable execution:
- Agent deployment
- Bandwidth control
- Test launches
- Cutover orchestration
Plan around throughput quotas early. For example, AWS Database Migration Service includes default caps such as 150 actively replicating source servers per region and 20 concurrent jobs. A “200 servers this month” target fails unless waves and limit increases are built into the design.
For data migration, separate transfer from validation.
Use migration services that support CDC and reconciliation queries you can run repeatedly. Then layer independent validation on top so correctness isn’t self-certified by the migration tool.
When moving large volumes of data (20 TB+), offline transfer options such as Google’s Transfer Appliance can be more predictable than network-based approaches. At that scale, predictability often matters more than theoretical throughput.
Phases 4-5: Cutover, Validate, Operate and Optimize
Cutover is controlled by gates, not optimism.
You need:
- Traffic switching and rollback criteria
- Automated data validation proving RPO and integrity
- Monitoring live before traffic shifts
After migration, stability depends on visibility.
Include:
- IAM and policy monitoring
- Performance monitoring
- Cost management to control cloud costs and optimize cloud spending
- Integration with incident workflows
If you defer these, you stabilize blind while cloud spending grows. According to Flexera’s State of the Cloud Report, 84% of enterprises struggle to manage cloud costs effectively.
Native vs. Third-Party, Intentionally
Use hyperscaler-native cloud migration tools when your migration stays within one cloud’s boundaries—standard virtual machines, common database paths, and a governance model aligned to that cloud’s IAM.
They start to break down when coordination spans multiple teams, clouds, or reporting layers. That’s where migrations lose visibility—status lives in different systems, cutover evidence is fragmented, and leadership can’t see risk clearly.
Bring in a third-party platform when coordination—not execution—is the bottleneck. If you’re stitching together status, dependencies, and cutover evidence across teams or clouds, a neutral control plane can reduce that overhead and make risk visible again.
Don’t default to “native equals simpler.” That’s a lazy heuristic. If a third-party tool becomes a parallel system of record, forces bespoke workflows, or duplicates what your cloud infrastructure and observability stack already provides, it’s just tool sprawl with a nicer UI. Choose the option that reduces risk with the fewest new moving parts your on-call team has to own.
Throughput Limits That Break Plans
Most migration schedules fail for a boring reason: You modeled the work as “we’ll just run more in parallel.” The problem is that your tools cap parallelism and “It works on my machine.” stops scaling. Your factory stalls. Teams cut validation to stay on schedule. By the time issues surface, you’re dealing with delayed launches, unplanned downtime, and a credibility hit with leadership.
A few common ceilings you should treat as first-class inputs to wave design:
- Discovery segmentation (Azure Migrate): one appliance can discover up to 10K servers, and an appliance registers to only one project. If you want parallel discovery streams, you’ll need multiple appliances and a governance plan that keeps projects from fragmenting.
- Assessment scale (Hyper-V): you can assess up to 35K Hyper-V servers per project, but each appliance discovers 5K VMs across up to 300 hosts. That shapes how you batch by cluster and ownership.
- Replication and cutover throughput (AWS MGN): defaults include 150 actively replicating source servers per Region and 20 concurrent jobs in progress. Your “200 servers/month” target can die on default quotas.
- Bulk data breakpoints (GCP Transfer Appliance): once you’re past roughly 20 TB, offline transfer (up to 1 PB) often beats pretending the network will cooperate.
Practically, you should turn these limits into a weekly throughput and resource allocation budget in Jira: appliances/projects and replication slots for key cloud services. Track cutover job slots and data lanes the same way, then staff waves to that budget instead of optimism.

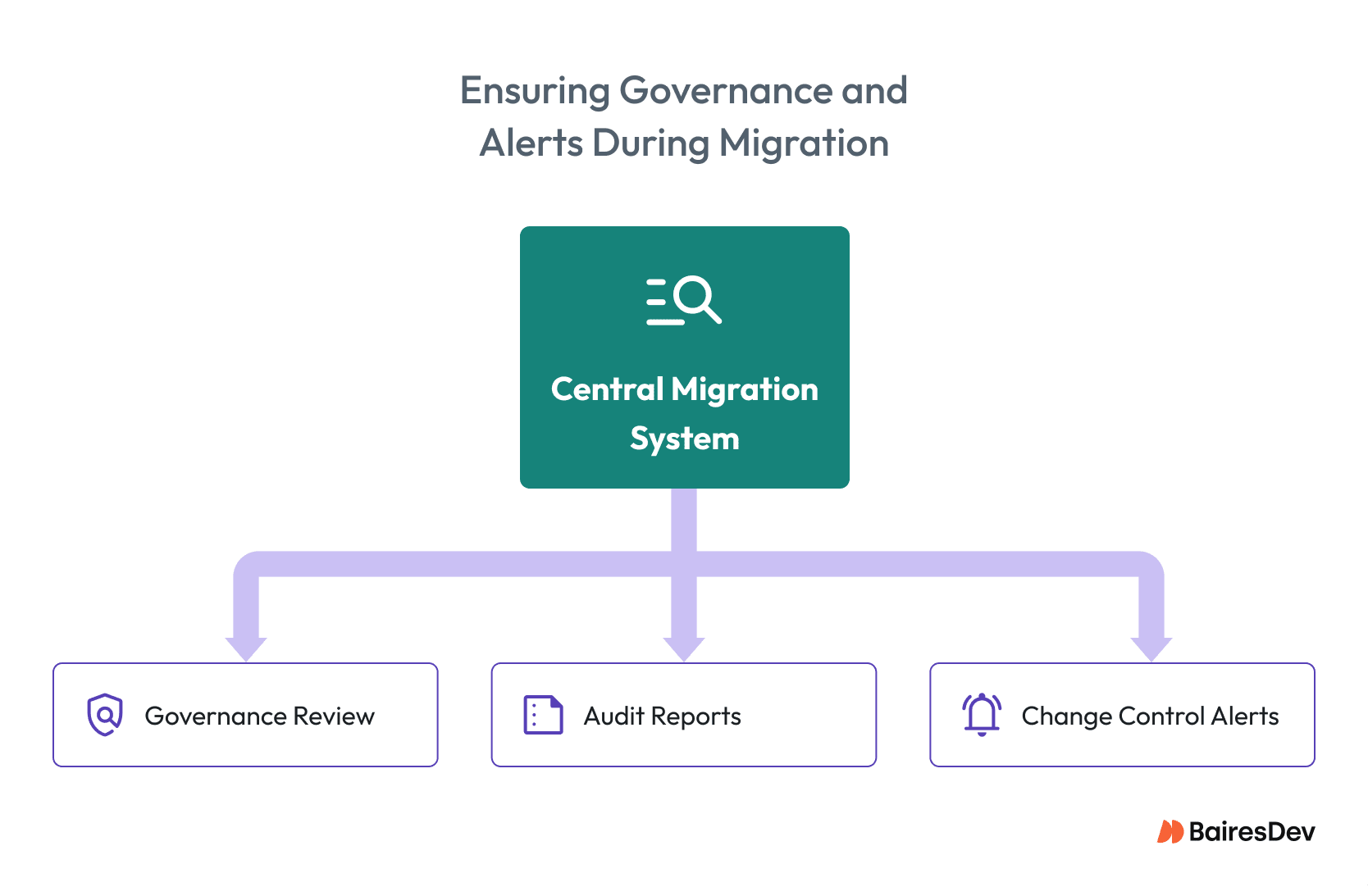

Security, Audit, and Change Control Hooks
When security and compliance fail, it usually means your migration tools are outside your control plane. Nobody can prove who changed what, when, and under whose approval. Governance isn’t paperwork you’ll “add later.” That kind of migration process flunks the Nicole Forsgren-style DORA question: can you prove control, fast?

Select tools that fit your IAM model and support data security, data encryption, and regulatory compliance requirements. Every replication agent install, test launch, cutover job, and rollback should produce audit logs you can route to your SIEM and link back to a Jira change ticket.
Also, force separation of duties in the tool itself. Don’t let the same human identity approve, execute, and override guardrails. Use role-based access, short-lived credentials, and service accounts tied to environments, so escalation has a real owner and an audit trail.
Cutover Readiness Gates
Cutover is a lot more than a change window. For instance, a Saturday cutover of a shared auth service can look fine until token refresh storms your new stack. Use hard gates you can’t waive in the moment. Think of them as airlock doors:
- Validation: automated correctness checks and RPO proof
- Rollback: explicit triggers, tested reversal steps, and time budget
- Monitoring: SLO-based alerts live before traffic shifts
- Ownership: named on-call, escalation path, and comms lead
- Downtime window: rehearsed timeline with stop points
Shortlist and Rationalize Your Stack
Standardize on a thin set of tool categories that produce the proof artifacts you’ve already decided you need: one system of record (Jira), one way you ship changes (GitHub plus IaC), one observability path, and one migration “factory” per cloud, no exceptions by default. If you’re telling yourself every team can choose its own migration tool because “they know their app,” you’re signing up for entropy.
Allow exceptions only when they reduce a named risk and still land evidence in the same control plane. It’s a good idea to keep your default online data path, but permit an offline transfer lane when the dataset crosses your network reality (say, 20 TB+) and require an owner, an integration plan, and an exit date.
Control, Not Tools, Determines the Outcome
Cloud migration doesn’t fail because teams picked the wrong tool. It fails because they couldn’t prove control—over data, downtime, and execution at scale.
A risk-first toolchain doesn’t eliminate complexity, but it makes it visible and manageable. That’s the difference between a migration that finishes and one that drags on under growing operational and business pressure.
